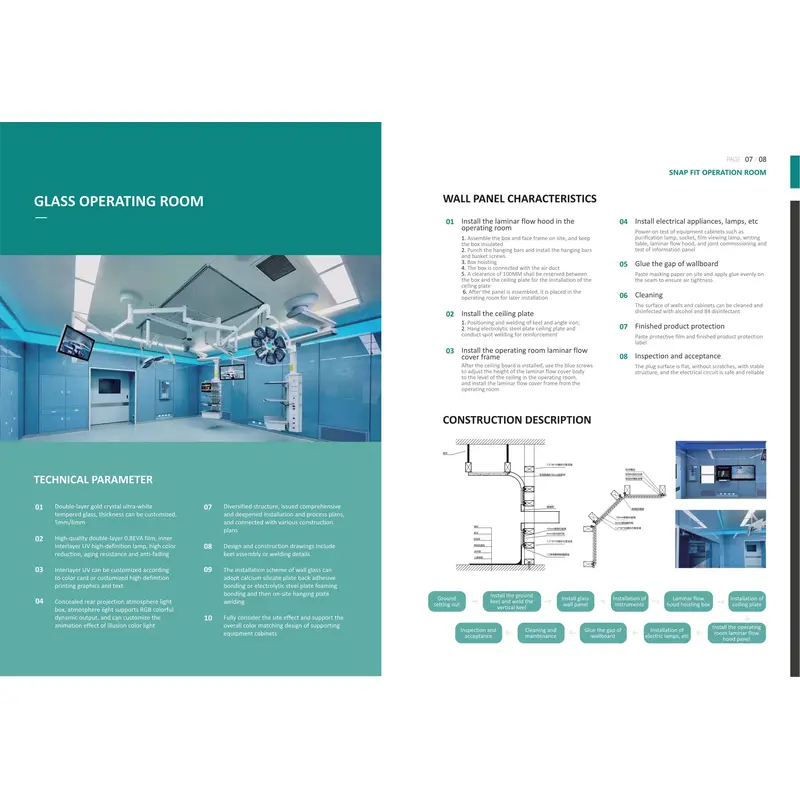

TECHNICAL PARAMETER

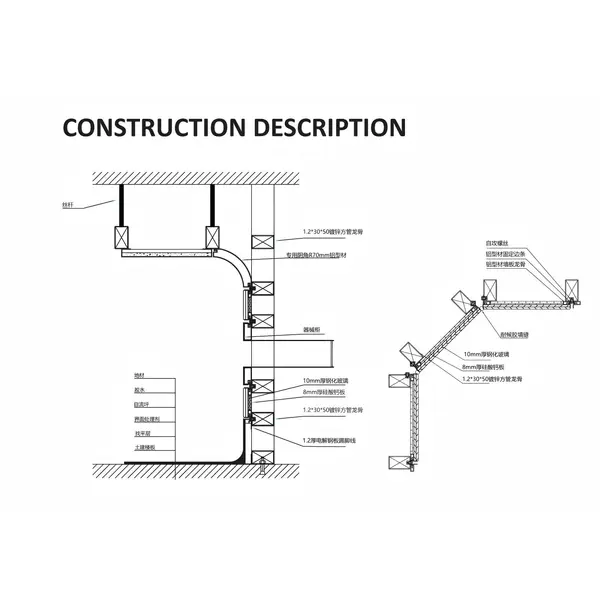

01Double-layer gold crystal ultra-whitetempered glass,thickness can be customized,5mm/6mm
07Diversified structure,issued comprehensiveand deepened installation and process plans,and connected with various constructionplans
02 High-quality double-layer 0.8EVA film,innerinterlayer UV high-definition lamp,high colorreduction,aging resistance and anti-fading

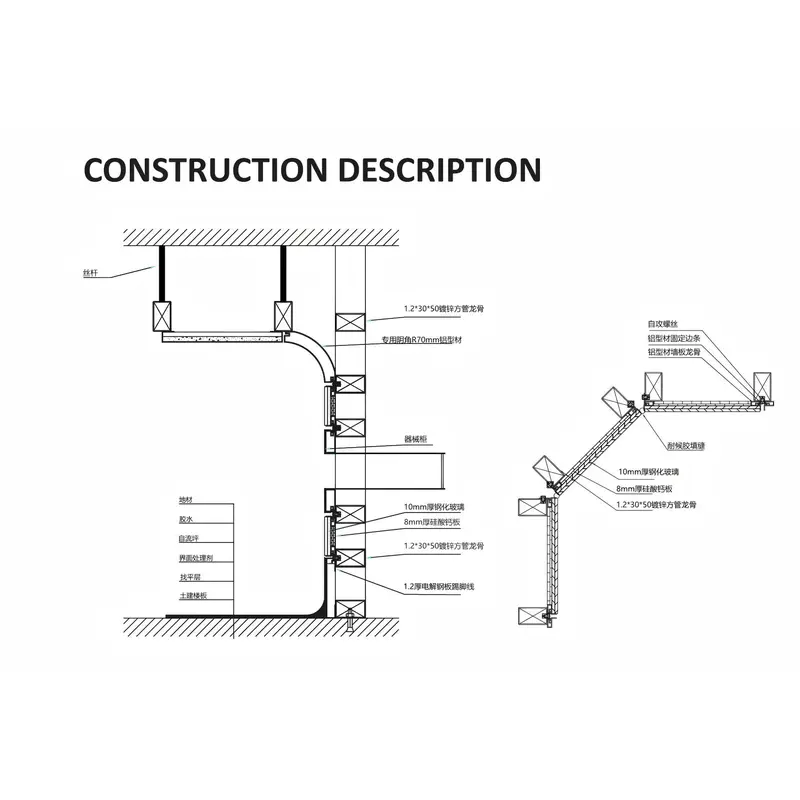

08Design and construction drawings includekeel assembly or welding details
03 Interlayer UV can be customized accordingto color card or customized high-definitionprinting graphics and text
04 Concealed rear projection atmosphere lightbox,atmosphere light supports RGB colorfuldynamic output,and can customize theanimation effect of illusion color light
09The installation scheme of wall glass canadopt calcium silicate plate back adhesivebonding or electrolytic steel plate foamingbonding and then on-site hanging platewelding
10Fully consider the site effect and support theoverall color matching design of supportingequipment cabinets
WALL PANEL CHARACTERISTICS
01 Install the laminar flow hood in theoperating room
04 Install electrical appliances,lamps,etc
1.Assemble the box and face frame on site,and keepthe box insulated2.Punch the hanging bars and install the hanging barsand basket screws3.Box hoisting4.The box is connected with the air duct5.A clearance of 100MM shall be reserved betweenthe box and the ceiling plate for the installation of theceiling plate6.After the panel is assembled,it is placed in theoperating room for later installation
Power-on test of equipment cabinets such aspurification lamp,socket,film viewing lamp,writingtable,laminar flow hood,and joint commissioning andtest of information panel
05 Glue the gap of wallboard
Paste masking paper on site and apply glue evenly onthe seam to ensure air tightness
06 Cleaning
02Install the ceiling plate1.Positioning and welding of keel and angle iron;2.Hang electrolytic steel plate ceiling plate andconduct spot welding for reinforcement
The surface of walls and cabinets can be cleaned anddisinfected with alcohol and 84 disinfectant
07Finished product protection
Paste protective film and finished product protectionlabel
03 Install the operating room laminar flowcover frameAfter the ceiling board is installed,use the blue screwsto adjust the height of the laminar flow cover bodyto the level of the ceiling in the operating room,and install the laminar flow cover frame from theoperating room
08 Inspection and acceptance
The plug surface is flat,without scratches,with stablestructure,and the electrical circuit is safe and reliable
